The PMI-SP, or PMI Scheduling Professional, is a specialized certification from PMI for professionals who focus on schedule development, control, and analysis. It is designed for project schedulers, planners, and project management practitioners who want to demonstrate advanced scheduling knowledge. Earning this credential can strengthen your credibility and support better project delivery outcomes.
| # | Exam Topics | Sub-Topics | Approximate Weightage (%) |
|---|---|---|---|
| 1 | Schedule Strategy | Schedule approach selection, scheduling standards, assumptions and constraints, schedule governance | 15% |
| 2 | Schedule Planning and Development | Activity definition, sequencing, duration estimating, network logic and baseline creation | 30% |
| 3 | Schedule Monitoring and Controlling | Progress measurement, variance analysis, forecasting, corrective actions | 30% |
| 4 | Schedule Closeout | Final schedule updates, lessons learned, closure reporting, records retention | 10% |
| 5 | Stakeholder Communications Management | Schedule reporting, stakeholder expectations, status communication, escalation handling | 15% |
The PMI-SP exam tests more than memorization. It checks your ability to apply scheduling concepts, interpret project situations, and choose the right actions across planning, monitoring, and communication tasks. Candidates need practical knowledge depth, strong schedule management judgment, and the ability to work through scenario-based questions efficiently.
QA4Exam.com offers Exam PDF and Online Practice Test materials that are built to help you prepare for the PMI-SP exam with confidence. The PDF includes actual questions and answers, while the practice test gives you a real exam simulation experience. Both formats are designed to keep the questions up to date and provide verified answers so you can study smarter. You also get valuable time management practice, which is essential for handling the exam under pressure. With focused preparation from QA4Exam.com, you can improve your readiness and aim to pass the PMI PMI-SP exam on your first attempt.
The PMI-SP exam is the PMI Scheduling Professional certification exam from PMI. It focuses on schedule strategy, planning, monitoring, controlling, closeout, and stakeholder communications management.
It is intended for project schedulers, planners, and professionals who work with project schedules and want to validate their scheduling knowledge and skills.
The exam can be challenging because it tests practical scheduling knowledge and scenario-based decision making. Strong preparation and familiarity with the exam topics can make it more manageable.
Braindumps alone are not the best approach. You should use them with a practice test and review the exam topics so you understand the logic behind the answers.
Hands-on experience is very helpful because the exam covers real scheduling tasks and practical judgment. Experience combined with targeted study gives you a stronger chance of passing on the first attempt.
The QA4Exam.com Exam PDF and Online Practice Test are designed to be a powerful preparation aid, but the best results come from using them to reinforce your understanding of the exam topics and answer patterns.
They help you study actual questions and answers, practice in an exam-like format, and improve time management. This combination can increase your confidence and readiness for the real PMI-SP exam.

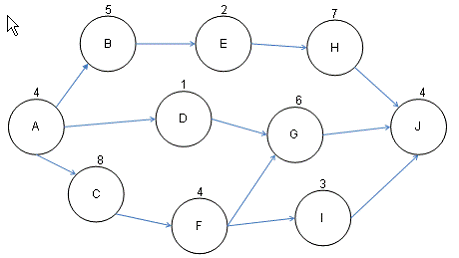

You are the project manager of the NHQ Project. You have created the project network diagram as shown in the figure:

Based on the project network diagram, how much float is available for Activity H if Activity B is delayed by four days and Activity D is delayed by two days?
The path of ABDHJ will take 21 days to complete and cannot exceed 27 days or else the project will
be late. If Activity B takes four additional
days and Activity D takes two additional days, this adds (4+2= 6) six days to the path, bringing the
path's duration to exactly (21+6 = 27)
twenty seven days. There is no available float left for Activity E or H.
Float or total float (TF) is the total amount of time that a schedule activity may be delayed from its
early start date without delaying the
project finish date, or violating a schedule constraint. It is calculated by using the critical path
method technique and determining the
difference between the early finish dates and late finish dates.
Answer options A, C, and B are incorrect. There is no float available because the path's duration has
increased to 27 days.
You are the project manager of the HQQ Project. Your project is running late by ten percent of where you should be at this time. Management is concerned and they'd like to know what is your schedule performance index. Considering that the project has a BAC of $567,899, you are thirty percent complete, and you have spent $179,450, what is the SPI for this project?
The schedule performance index is found by dividing the earned value by the planned value. In this
instance, the planned value is ten percent more than where the project is forty percent of the
budget at completion.
Schedule performance index (SPI) is the measure of schedule efficiency on a project. It is used in
trend analysis to predict future performance.
SPI is the ratio of earned value to planned value. The SPI is calculated based on the following
formula:
SPI = Earned Value (EV) / Planned Value (PV)
If the SPI value is greater than 1, it indicates better than expected performance, whereas if the value
is less than 1, it shows poor
performance. The SPI value of 1 indicates that the project is right on target.
Answer option C is incorrect. 0.95 is the project's cost performance index.
Answer options A and D are incorrect. An index is a decimal value.
Which of the following characteristics of conflict and the conflict management process should be recognized by the project managers while handling conflict in a team environment? Each correct answer represents a complete solution. Choose all that apply.
The characteristics of conflict and the conflict management process recognized by the
project managers while handling conflict in a team
environment are as follows:
Conflict is natural and forces a search for alternatives.
Openness resolves conflict.
Conflict resolution should focus on issues, not personalities.
Conflict is a team issue.
Conflict resolution should focus on the present, not the past.
Harry works as a project manager for BlueWell Inc. A risk that has been identified and analyzed in the project planning processes is now coming into fruition. Who among the following is responsible for implementing the risk responses or contingency plan?
The risk owner is the individual on the project team that is closest to the risk event. The risk owner
can be an individual or an organization
responsible for implementing risk responses or contingency plan. The risk owner should be
empowered with the ability to respond to the risk
as it was planned.
Answer option B is incorrect. Harry is the project manager and likely would not be the risk owner as
well.
Answer option C is incorrect. The project sponsor authorizes the project but does not participate in
execution of the project.
Answer option D is incorrect. While a subject matter expert may be the risk owner on some
occasions, he would not be the risk owner on
every occasion.
Jack works as a project manager for the NHQ project. His project has a budget of $2,208,456 and is scheduled to last for three years. His project is currently forty percent complete though it should be forty-five percent complete. In order to reach this point of the project, he has spent $725,000. Management needs a performance report regarding the NHQ project. Management is concerned that this project will be over budget upon completion. Management would like to create a report telling them how much more the project will need to complete. What value should Jack tell the management?
The project will need $1,087,497.74 more to complete. This formula, the estimate to complete, is estimate at completion minus the actual costs. Here,
CPI = EV/AC
= (0.40*2,208,456)/725,000
= 1.21846, and
ETC = EAC - AC
= (BAC/CPI) - AC
= (2,208,456/1.21846) - 725,000
= 1,812,497.74 - 725,000
= 1,087,497.74
The estimate to complete (ETC) is the expected cost needed to complete all the remaining work for a
scheduled activity, a group of activities,
or the project. ETC helps project managers predict what the final cost of the project will be upon
completion. The formula for the ETC is EAC-
AC. The EAC is BAC/CPI.
